ITEM: |
INFORMATIONAL
ITEMS/STAFF REPORTS |
||||
|
|||||
23. |
CARMEL RIVER FISHERY REPORT FOR SEPTEMBER
2014 |
||||
|
|||||
Meeting Date: |
October 20, 2014 |
Budgeted: |
N/A |
||
|
|||||
From: |
David J. Stoldt, |
Program/ |
N/A |
||
|
General Manager |
Line Item No.: |
|||
|
|
|
|||
Prepared By: |
Beverly Chaney |
Cost Estimate: |
N/A |
||
|
|||||
General
Counsel Review: N/A |
|||||
Committee Recommendation: N/A |
|||||
CEQA Compliance: N/A |
|||||
AQUATIC HABITAT AND FLOW
CONDITIONS: During September
2014, Carmel River streamflow at the MPWMD Highway 1 gage (HW 1) was 0
cubic-feet per second (cfs). As of September 30, the wetted river front remained
near Robinson Canyon Road Bridge (River Mile, [RM], 8.46). An additional 2.4 miles of stream was dry or
intermittent in the reach between West Garzas Well, (RM 12.1) and Rosie’s
Bridge (Esquiline Road, RM 14.5).
Mean daily streamflow in
September at the District’s Carmel River at Sleepy Hollow Weir gaging station
ranged from 1.6 to 3.4 cfs, with a mean monthly flow of 1.94 cfs. During September,
0.19 inches of rainfall were recorded at California American Water’s (CAW) San
Clemente Dam (SCD). The rainfall total for WY 2014 (which started on
October 1, 2013) is 10.61 inches, or 49.8% of the long-term annual average of
21.29 inches.
CARMEL RIVER
LAGOON: In September 2014, the

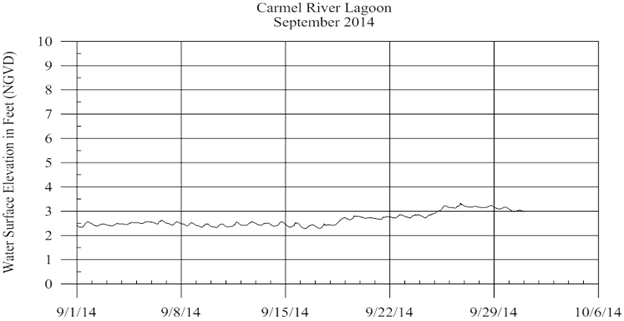

lagoon’s water-surface elevation (WSE) rose from 2.4 to 3.2 feet above mean sea
level (see graph below). Surface inflow to the lagoon ceased on May
24, 2013.
Water quality profiles
were conducted in late September at five lagoon sites. While much of the lagoon remained shallow, water
temperatures began to cool, ranging from 63 - 69 degrees F. Dissolved oxygen (DO) levels were variable
and ranged from 0.5 – 10 mg/L, while salinity levels remained low at 1.5 - 3
ppt.
LOWER RIVER STEELHEAD
RESCUES: Staff began steelhead smolt and juvenile rescues on March 3, 2014, the
earliest rescue start since 1991. By
the end of September, a total of 3,585 fish had been rescued, including: 873
smolts, 2,215 non-smolted juveniles, 490 young-of-year (YOY), six adults, and
one mortality. The YOY fish are progeny
from non-sea run spawning adults – possibly the large fish released from the
Sleepy Hollow Steelhead Rearing Facility last fall. The smolts and adults were acclimated to
seawater then released into the ocean at Stewart’s Cove, near the Carmel River
mouth. The juveniles and YOY were
transported farther upstream and released.
SPAWNING GRAVEL ENHANCEMENT
PROJECT AT LOS PADRES: In 2013,
Staff received a $170,000 grant from the California Department of Fish and
Wildlife (CDFW) Fisheries Restoration Grant Program (FRGP) for the purchase and
placement of spawning gravels below Los Padres Dam. Natural gravel is now trapped behind the dam
causing the substrate downstream to become too coarse for adult steelhead spawning. With the addition of 1,500 tons of clean,
river-run, 1.5 – 4 inch gravel, staff hopes to increase available spawning
habitat through the Cachagua area by 50% as the rock migrates downstream each
winter.
Project planning and permitting were completed in July 2014 and the Assured
Aggregates, Co. began the six weeks of gravel deliveries to the stockpile site in
mid-August. Gravel placement began on
September 24 and was completed on September 29, 2014 by the Don Chapin, Co.

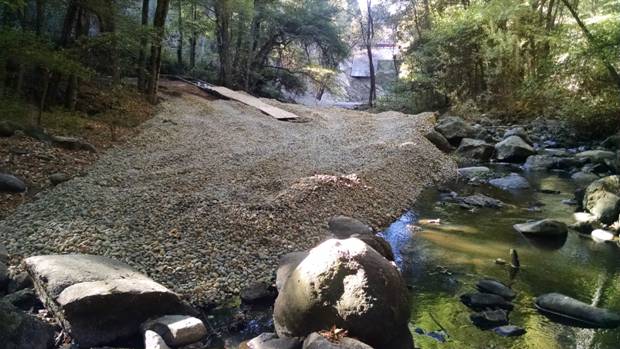

using a conveyor-truck and loader combination (see photos below). Once river flows increase this winter, the
gravel will start to disperse downstream, seeding spawning glides throughout
the reach.
This year’s project continues the 20-year spawning gravel enhancement
program started by the District in 1993.
With the completion of the this project, the District will have placed
approximately 4,900 tons of gravel between Los Padres Dam and Sleepy Hollow,
downstream of San Clemente Dam.
Approximately 800 tons of 1.5 - 4 inch gravel was placed in the Los
Padres Dam plunge pool using a conveyor-truck to disperse the material from the
cliff above.
Approximately 300 tons of 1.5 – 4 inch gravel was placed with a loader along
the bank near the “old fish ladder” (no longer in use). An additional 400 tons were placed along the
river ~100 meters downstream at the “old road crossing” site.
U:\staff\Boardpacket\2014\20141020\InfoItems\23\item23.docx
