ITEM: |
INFORMATIONAL
ITEMS/STAFF REPORTS |
||||
|
|||||
19. |
CARMEL RIVER FISHERY REPORT FOR AUGUST 2019 |
||||
|
|||||
Meeting Date: |
September 16, 2019 |
Budgeted: |
N/A |
||
|
|||||
From: |
David J. Stoldt, |
Program/ |
N/A |
||
|
General Manager |
Line Item No.: |
|
||
|
|
|
|||
Prepared By: |
Beverly Chaney |
Cost Estimate: |
N/A |
||
|
|||||
General
Counsel Review: N/A |
|||||
Committee Recommendation: N/A |
|||||
CEQA Compliance: This action does not
constitute a project as defined by the California Environmental Quality Act
Guidelines Section 15378. |
|||||
AQUATIC HABITAT AND FLOW
CONDITIONS: Carmel River flows
dropped slightly in August but remained above typical summer levels, providing
good to fair rearing conditions for steelhead young-of-the-year (YOY)
throughout much of the watershed.
August’s mean daily streamflow at the Sleepy Hollow Weir dropped
from 20 to 15 cubic-feet-per-second (cfs) (monthly mean 17.3 cfs) resulting in 1,060
acre-feet (AF) of runoff. Mean daily streamflow at the Highway 1 gage dropped
from 7.2 to 4.7 cfs (monthly mean 5.8 cfs) resulting in 357 acre-feet (AF) of
runoff. Los Padres Dam stopped spilling on August 5th, but ~14 cfs are being
released through the dam’s outlet works. A problem with the outlet pipe
occurred mid-month due to the large landslide in the reservoir when the pipe
became partially blocked with debris.
The issue was resolved a few days later by divers in the reservoir but
the situation needs to be closely monitored.
There were 0.00 inches of rainfall in August as recorded at
the San Clemente gauge. The rainfall total for WY 2019 (which started on
October 1, 2018) is 30.93 inches, or 146% of the long-term year-to-date average
of 21.15 inches.
CARMEL RIVER LAGOON: The lagoon mouth was closed by Monterey County
crews on July 10, 2019 by pushing beach sand across the western side of the lagoon.
In August, the water surface elevation (WSE) held steady between ~10.2 to 10.5
feet (North American

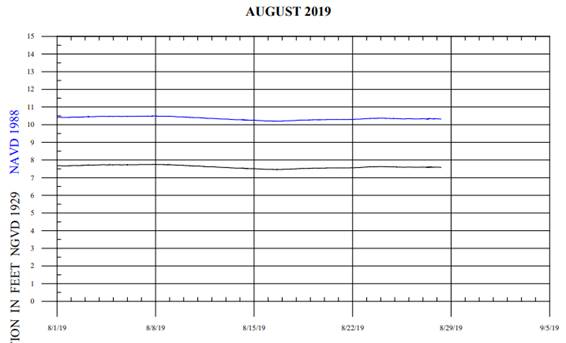

Vertical Datum of 1988; NAVD 88) (see graph below) providing important additional summer
habitat.
Water quality
depth-profiles were conducted at five sites on August 19, 2019 while the lagoon
mouth was closed, the water surface elevation was ~10.25 feet, and river inflow
was 5.3 cfs. Steelhead rearing conditions were generally “fair” throughout the
lagoon, salinity was <1 ppt down to 2.5 m depth in the south arm, dissolved
oxygen (DO) levels were variable from 1 - 10 mg/l, and water temperatures remained
between 68 - 73 degrees F.
TRIBUTARIES STEELHEAD
RESCUES: Staff began
fish rescues in the tributaries in early May. As of August 31, a total of 15,013
fish has been rescued, including: 14,933 young-of-the-year (YOY), 23 age 1+
fish, with 57 mortalities (0.4%). The majority of the fish have been rescued
from Hitchcock Creek (3,114) and Cachagua Creek (9,714).
MAINSTEM STEELHEAD
RESCUES: No rescues
have been needed this year in the mainstem due to higher than usual summer
flows. Staff continues to monitor the conditions.
SLEEPY HOLLOW STEELHEAD
REARING FACILITY: General
contractor Mercer-Fraser Company of Eureka, CA, was hired for the Intake
Upgrade Project and started construction in September 2018 on the $2 million
project. The main features of the project include installing a new intake
structure that can withstand flood and drought conditions as well as the
increased bedload from the San Clemente Dam removal project, and a new
Recirculating Aquaculture System (RAS) that can be operated in times of low
flow or high turbidity to keep the fish healthy.
During July and August 2019, the project moved towards completion
with the construction of the RAS building, including the installation of the
plumbing and components (drum filters, UV sterilizer, sump tank, and
electrical) and installation of the degassing/oxygenation system. Telemetrix Co. of
Marina was hired to setup the monitoring and alarm systems.
SPAWNING GRAVEL
ENHANCEMENT PROJECT AT LOS PADRES: The
District is currently partnering with Cal-Am Water to complete another round of
spawning gravel enhancement below Los Padres Dam. Cal-Am is funding the
purchase and placement of 1,000 tons of 1.5-4” river-run gravel, while the
District obtained the required permits, and is providing the project expertise,
onsite project management and reporting, and the required Approved Biologist
for the federal permits.
Natural gravel is now trapped behind the dam causing the substrate
downstream to become too coarse for adult steelhead to spawn in. The 1,500 tons of 1.5 – 4 inch gravel placed
by the District in 2014 was very successful in providing crucial spawning
habitat in the Cachagua area. As that material moves downstream each winter
additional material needs to be placed upstream to keep the reach seeded. With
the addition of 1,000 tons of gravel in 2019 and another 1,000 tons in 2020, we
hope to the increase available spawning habitat and continue the upward trend
in steelhead spawning success in the upper Carmel River. Permitting was

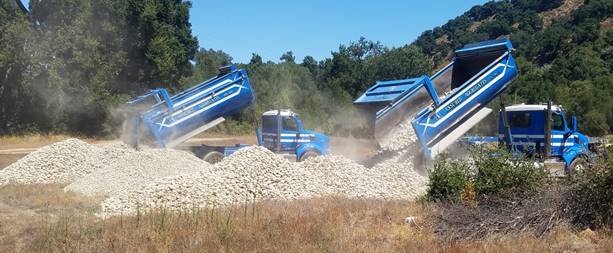

completed in July 2019 and gravel deliveries were completed over two weeks in
August (see photo below). Staff plans to begin gravel placement in mid-September.
This year’s project continues the 26-year
Spawning Gravel Enhancement Program started by the District in 1993. With the
completion of the this year’s project, the District will have placed
approximately 5,900 tons of gravel between Los Padres Dam and Sleepy Hollow,
downstream of San Clemente Dam.
U:\staff\Boardpacket\2019\20190916\InfoItems\19\Item-19.docx
